Canadian working day use cases

Follow worked examples for court filings, property closings, employee leave and project schedules. Each shows the calculator settings and the result. For help using the calculator, see the Canada guide. For more on specific deadlines, browse Articles.

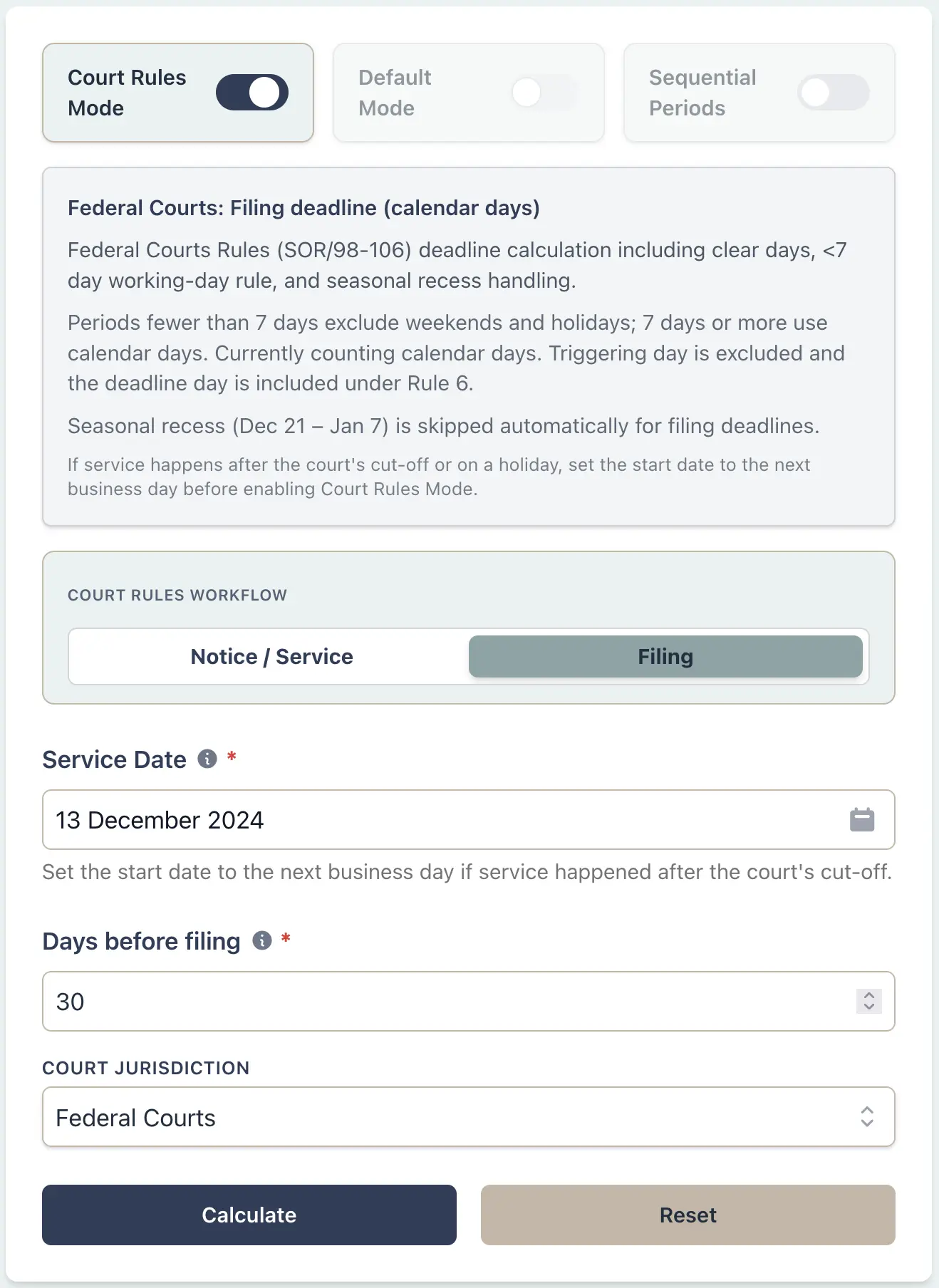

Appeal lawyer: find the deadline for a respondent's memorandum

You are counsel for the respondent in a Federal Court of Appeal case. The appellant's memorandum of fact and law was served on the respondent on 11 December 2026. Rule 346(2) gives you 30 days after service to serve and file the respondent's memorandum. The seasonal recess interrupts the count: Rule 6(3) excludes Dec 21 to Jan 7 unless the Court directs otherwise, and no different direction applies in this example. You need the deadline to plan drafting, client review, service and filing over the holiday period.

Settings, in form order

Calculation type
Deadline
Use court rules
On
Court jurisdiction
Federal Courts
Court rule
Federal Courts: Filing deadline
Optional court rules
Exclude Dec 21 to Jan 7
Service date
11 December 2026
Number
30
Unit
Days
Open this example in the calculator

Result

Thursday 28 January 2027

The count excludes the service day and the seasonal recess. Both service and filing are required. Check for any court direction that changes the period, and confirm the service method and filing requirements before using this date. Before calculating, review How this will be counted.

Federal Court deadline calculation
Calendar evidence. Select the image to view it full size.
View calculator setup
Calculator setup for a respondent's memorandum deadline
Select the image to view the setup full size.

Real estate lawyer: find a closing date from the agreed working-day period

You are a real estate lawyer in Ontario helping a buyer arrange their house purchase. The Agreement of Purchase and Sale becomes firm on 9 January 2026. The parties have agreed to close 15 working days later, excluding the firm date and counting the closing day. Their agreement defines working days as Monday to Friday, excluding Ontario statutory holidays. You need the closing date so the buyer can book movers and the lender can arrange the funds.

Settings, in form order

Calculation type
Deadline
Use court rules
Off
Counting method
Business days
Jurisdiction
Ontario
Additional excluded periods
None
Include the start date
Off
Include the deadline date
On
Start date
9 January 2026
Number
15
Unit
Days
Direction
Forward
Open this example in the calculator

Result

Friday 30 January 2026

Working-day counting produces a clear closing date for coordination with lender funding, title transfer, and completion logistics.

Ontario closing deadline calculation
Calendar evidence. Select the image to view it full size.
View calculator setup
Real estate closing deadline calculation
Select the image to view the setup full size.

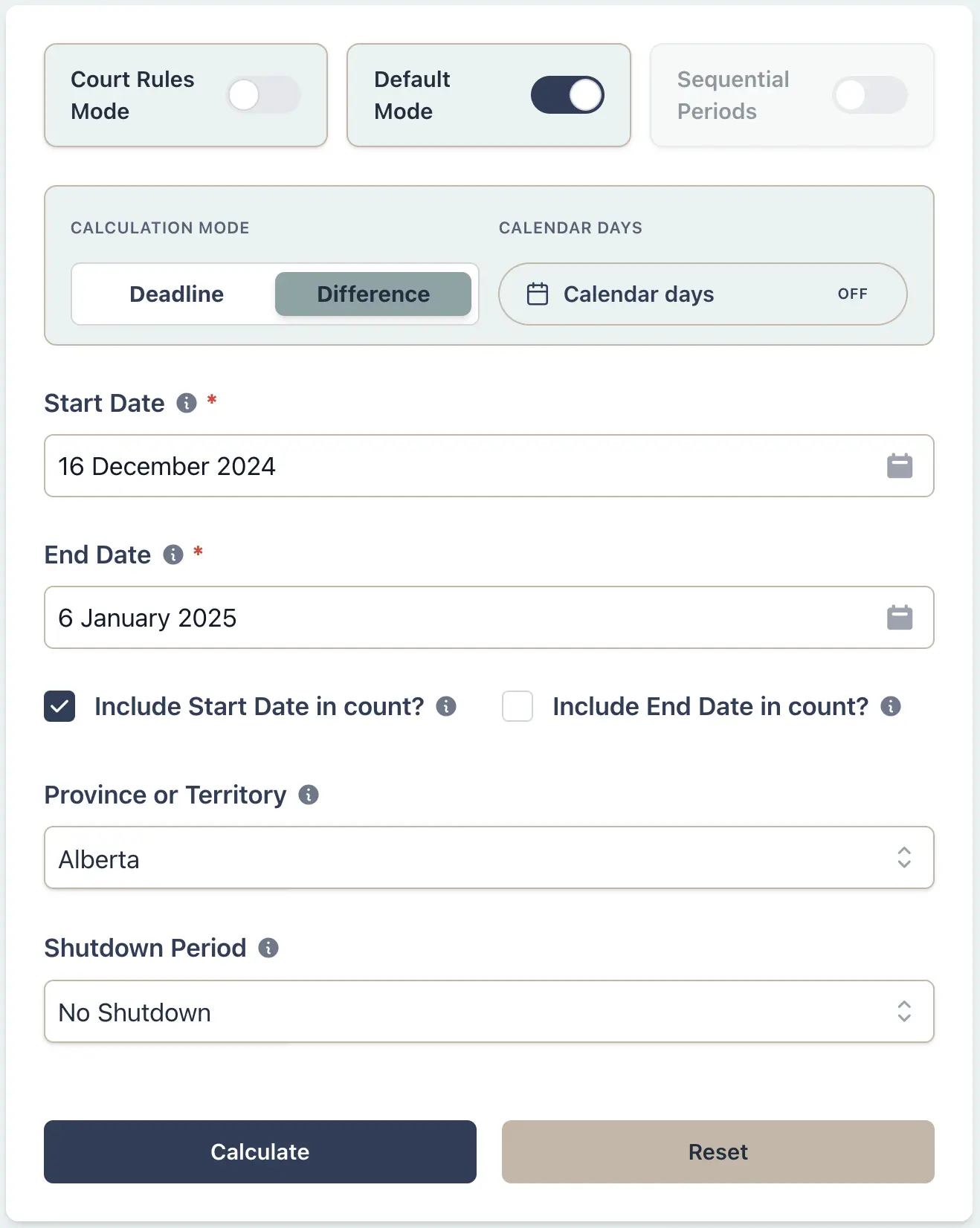

HR payroll specialist: count working days in an employee's leave period

You manage payroll at an Alberta technology company. An employee who normally works Monday to Friday has requested unpaid leave starting on 14 December 2026 and will return on 4 January 2027. The office stays open on its usual working days over Christmas and New Year. You need to count the working days they will be away, then check their holiday-pay eligibility and the company's leave policy before updating payroll.

Settings, in form order

Calculation type
Days between
Counting method
Business days
Jurisdiction
Alberta
Additional excluded periods
None
Include the start date
On
Include the end date
Off
Start date
14 December 2026
End date
4 January 2027
Open this example in the calculator

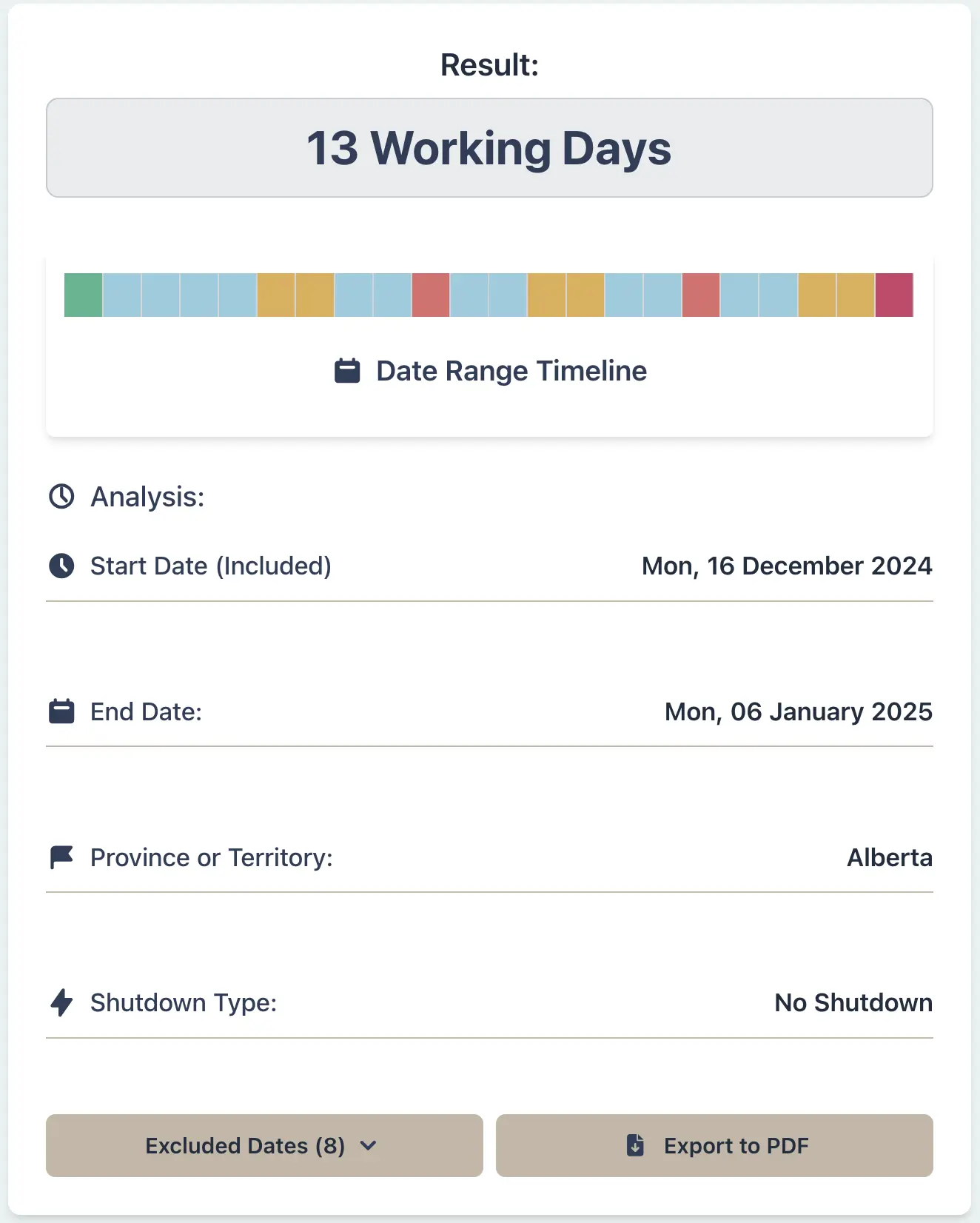

Result

13 working days

The count includes the first day away and excludes the return-to-work date. Check the employee's work pattern, holiday-pay eligibility and leave policy before deciding how to record the absence or adjust pay. After calculating, review the day count and Non-working dates.

Alberta working-day count for an employee absence
Calendar evidence. Select the image to view it full size.
View calculator setup
Calculator setup for an Alberta employee absence
Select the image to view the setup full size.

Procurement manager: find the notice date for ending a vendor contract

You are the procurement manager at a British Columbia software company. You plan to end a software licensing agreement effective 16 March 2026. You have checked that the contract requires ten full working days between the notice date and the termination date, excluding weekends and BC provincial holidays. You need to work back from the termination date so you can arrange written notice using the contract's delivery requirements and avoid an unwanted renewal.

Settings, in form order

Calculation type
Deadline
Use court rules
Off
Counting method
Business days
Jurisdiction
British Columbia
Additional excluded periods
None
Include the start date
Off
Include the deadline date
Off
Start date
16 March 2026
Number
10
Unit
Days
Direction
Backward
Open this example in the calculator

Result

Friday 27 February 2026

The count leaves both the notice date and termination date out. Check when notice takes effect under the contract and allow time for the agreed delivery method.

Contract termination notice deadline calculation
Calendar evidence. Select the image to view it full size.
View calculator setup
Contract termination notice workflow
Select the image to view the setup full size.

Construction project manager: plan a restart around the CCQ summer holiday

You manage a commercial construction project in Montreal that will pause for the CCQ summer holiday. The official CCQ construction holiday runs from 19 July (00:01) through 1 August 2026 (24:00). You issue a planning notice on 18 July 2026. Your project schedule allows 14 working days after that notice to prepare for restarting, leaving out weekends and the shutdown and counting the target restart day. You need a target date to coordinate deliveries and the trades returning to the site.

Settings, in form order

Calculation type
Deadline
Use court rules
Off
Counting method
Business days
Jurisdiction
Quebec
Statutory holiday treatment
Standard public-holiday calendar
Additional excluded periods
Quebec construction — summer shutdown (CCQ calendar)
Include the start date
Off
Include the deadline date
On
Start date
18 July 2026
Number
14
Unit
Days
Direction
Forward
Open this example in the calculator

Result

Thursday 20 August 2026

The target is the fourteenth working day after the notice, with the shutdown left out. This preparation period comes from the project schedule; the CCQ holiday calendar does not impose a fourteen-day restart buffer.

Quebec construction restart calculation
Calendar evidence. Select the image to view it full size.
View calculator setup
CCQ summer shutdown schedule planning
Select the image to view the setup full size.

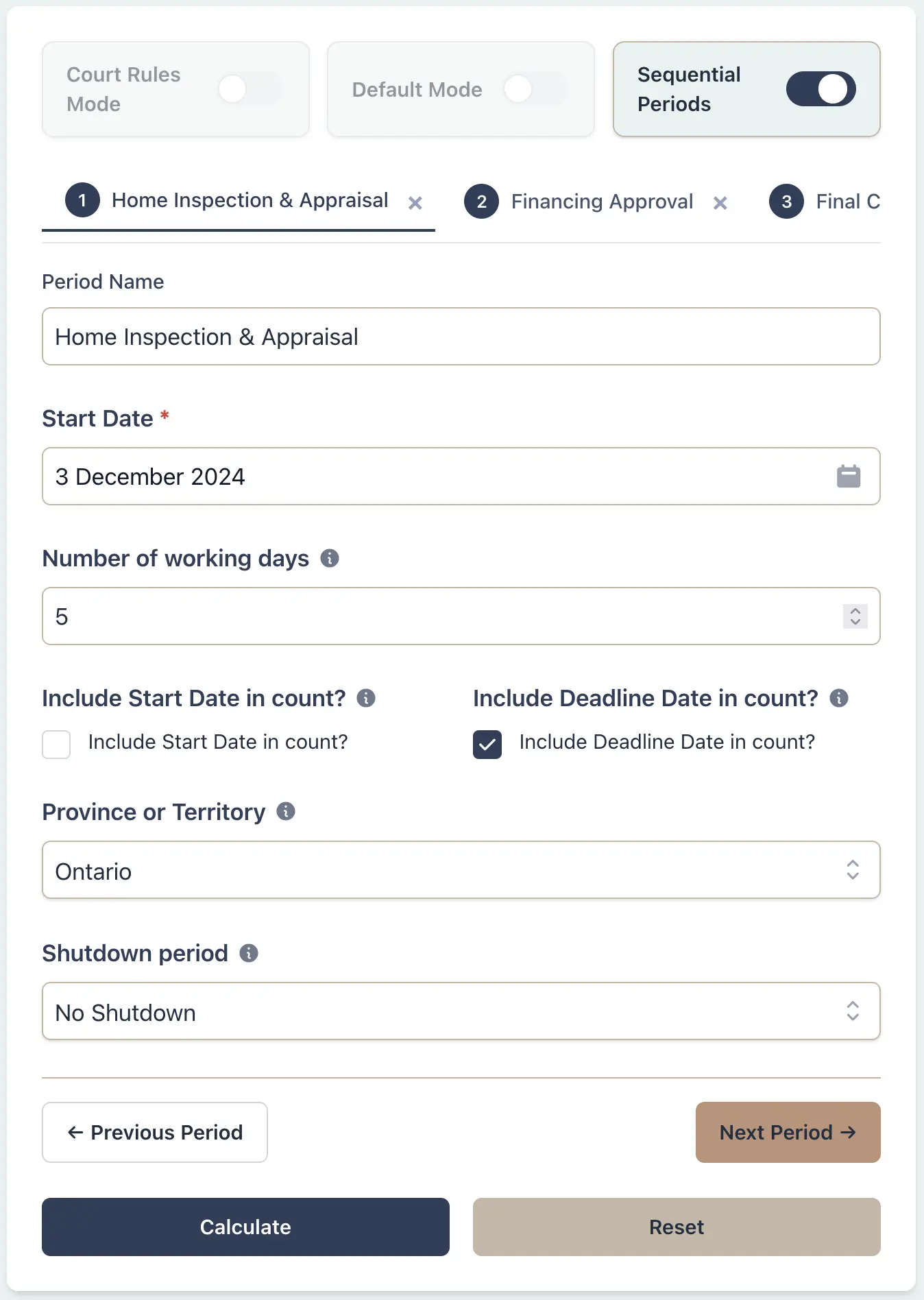

Real estate lawyer: plan inspection, financing and closing in sequence

You are a real estate lawyer in Ontario helping a buyer plan a purchase. The offer was accepted on 1 December 2026. Your team has allowed five working days for inspection and appraisal, five more for financing approval, and twenty more for closing preparations. For planning, each stage starts on the previous stage's target date. Your firm closes over year-end (Dec 24 – Jan 2), so your internal schedule leaves those days out. You need the three target dates to coordinate with the buyer, inspector and lender, while checking the signed agreement's deadlines separately.

Settings, in form order

Calculation type
Sequential
Start date
1 December 2026

Home Inspection & Appraisal

Counting method
Business days
Jurisdiction
Ontario
Additional excluded periods
Law firm year-end closure (24 December – 2 January)
Include the start date
Off
Include the deadline date
On
Number
5
Unit
Days
Direction
Forward

Financing Approval

Counting method
Business days
Jurisdiction
Ontario
Additional excluded periods
Law firm year-end closure (24 December – 2 January)
Include the start date
Off
Include the deadline date
On
Number
5
Unit
Days
Direction
Forward

Final Closing

Counting method
Business days
Jurisdiction
Ontario
Additional excluded periods
Law firm year-end closure (24 December – 2 January)
Include the start date
Off
Include the deadline date
On
Number
20
Unit
Days
Direction
Forward
Open this example in the calculator

Result

Period 1 (inspection/appraisal)

Tuesday 8 December 2026

Period 2 (financing)

Tuesday 15 December 2026

Period 3 (final closing)

Thursday 21 January 2027

Sequential uses each target date as the next period's start date. These are internal planning targets that include the firm's closure. An office closure does not itself extend a contractual deadline; confirm the dates in the signed agreement. If a stage finishes on a different date, update the plan. After calculating, review each period’s settings and target date.

Calculator result showing three chained periods marked on the calendar, with holidays shaded
Calendar evidence. Select the image to view it full size.
View calculator setup
Real estate transaction sequential deadline workflow
Select the image to view the setup full size.
